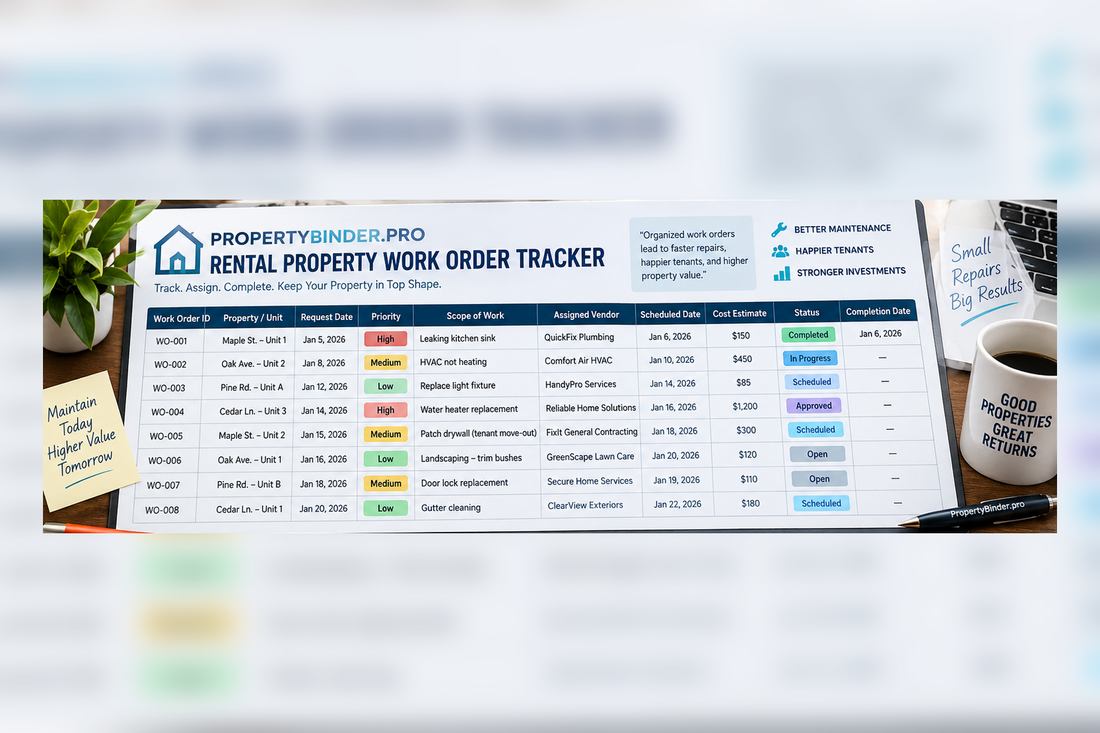

Rental Property Work Order Tracker: From Scope to Closeout
A rental property work order tracker manages the actual job after a maintenance need has been approved. It should show the scope of work, property, priority, assigned vendor or technician, schedule, access arrangements, estimate or authorization, completion evidence, invoice status, warranty information, and final closeout. The key difference from a maintenance request log is that a work order is task-centered: it tells someone what work has been authorized and what must happen before the job can be closed.
A good tracker does not replace a signed contract, licensed trade requirements, permit rules, local habitability law, or emergency procedures. It keeps the operational facts organized.
Quick answer: what should a work order tracker include?
- Work order ID
- Related maintenance request ID
- Property and unit
- Scope of work
- Priority
- Assigned vendor or technician
- Contact information
- Schedule
- Access notes
- Estimate or authorization amount
- Materials or parts notes
- Status
- Completion date
- Invoice reference
- Warranty or callback period
- Verification and closeout status
Why work orders need a defined scope
“Fix bathroom” is not a work order. A useful scope might say: “Inspect active leak at toilet supply connection, stop leak, replace failed connector if needed, test for leaks after repair, photograph completed work, and report any visible moisture damage requiring separate remediation.” Specific scope reduces misunderstandings and creates a basis for comparing completion with what was authorized.
1. Link every work order to the original request or inspection finding
When the job starts from a resident report, carry over the request ID from the Maintenance Request Log. When it starts from an owner inspection or preventive task, reference that record instead. The work order should never appear as an unexplained standalone expense.
2. Keep the reported problem separate from the authorized work
The original issue may say “bathroom ceiling stain.” The approved work may become “inspect upstairs tub drain, repair leak, dry affected area, assess drywall after moisture source is corrected.” Keeping both fields preserves the history while preventing the initial symptom from being mistaken for the final diagnosis.
3. Assign one responsible party
Record who owns the job: named vendor, employee, contractor, or owner. If several trades are involved, create separate work orders or sub-tasks instead of putting every person into one vague record. Clear ownership makes scheduling, invoice matching, and follow-up much easier.
4. Record authorization and cost without turning the tracker into accounting software
Include estimate amount, approved cap, change authorization, and final invoice reference when useful. The detailed payment transaction belongs in the Income & Expense Log and receipt/invoice records. The work-order tracker should explain what the cost was for and whether it matched the authorized scope.
5. Include access notes carefully
Record the approved access plan, resident contact requirement, pets, lockbox process, or manager presence if relevant. Do not print permanent access codes or passwords on general work orders that circulate among vendors. Entry rights and notice requirements vary, so schedule work in accordance with the lease and local law.
6. Use a status that reflects the real state of the job
Useful statuses include approved, assigned, scheduled, in progress, awaiting parts, waiting for access, completed-pending-review, verified, and closed. “Completed” should mean the technician reports the work done. “Verified” means the owner, manager, or resident confirmation shows the function was restored or the defined scope was satisfied.
7. Collect completion evidence
Ask for a completion note, invoice, photos when appropriate, replaced-part information, and any warranty or return-visit terms. For moisture work, evidence should also show that the water source was addressed. EPA guidance emphasizes moisture control and prompt drying because surface cleanup alone does not solve an ongoing water problem.
8. Capture safety-related work clearly
If the work involves smoke alarms, CO alarms, electrical hazards, structural concerns, or other safety systems, record what was tested and what remains open. CPSC recommends monthly testing of smoke and CO alarms and annual battery replacement for alarms that use replaceable batteries. Local codes and device instructions may add requirements.
9. Preserve warranty and callback information
Record parts warranty, labor warranty, manufacturer warranty, and the date through which a callback is expected to be covered. If the same issue reappears during that period, link the new request to the original work order instead of treating it as unrelated.
10. Close the work order only after review
Use the Repair Follow-Up Checklist to confirm function, documentation, invoice consistency, cleanliness, unresolved damage, and recheck needs. The final close date should come after verification, not automatically when the contractor submits an invoice.
11. Convert recurring work into preventive maintenance
If the same systems repeatedly generate work orders, use the history to update the Preventive Maintenance Schedule or replacement planning. The value of a tracker is not only proving what was done; it is showing which repairs keep coming back.
A practical work order lifecycle
- Identify the approved need.
- Write the scope.
- Assign a work order ID.
- Authorize vendor and budget.
- Schedule access.
- Track parts or dependencies.
- Complete the work.
- Collect evidence and invoice.
- Verify the result.
- Record warranty/recheck.
- Close and archive.
Common work-order mistakes
- Vague scope such as “fix plumbing”
- No link to the original request
- No named owner for the next action
- Storing access credentials in vendor paperwork
- Paying an invoice with no completion record
- Closing the job before verification
- Losing warranty details
- Repeatedly repairing the same system without reviewing replacement options
How this fits into the PropertyBinder system
The Property Management Binder provides the wider property record around each work order: maintenance history, inspections, vendor information, asset details, and incident records. The work-order tracker turns that context into a controlled job record that can be followed from authorization through closeout.
FAQ
Is a maintenance request the same as a work order?
No. A request reports a problem. A work order authorizes and tracks specific work.
Should every maintenance request create a work order?
Not necessarily. Some requests need information, inspection, owner action, or another resolution before any vendor work is authorized.
Should I record estimates and final costs?
Yes, as references useful for controlling the job, while keeping detailed accounting in the financial records.
Who should verify the work?
The appropriate person depends on the job. It may be the owner, manager, resident, qualified technician, or inspector. High-risk work may require licensed or code-specific verification.
Track scope changes and approvals separately
Repairs often change after the technician opens the wall, tests the equipment, or finds a second failed component. Do not silently overwrite the original work order. Keep the approved scope, then add a change note showing what new condition was found, what additional work was proposed, who authorized it, the date, and any revised cost or schedule. This preserves a clean history of what the owner originally approved and why the job changed.
If parts are returned, substituted, or backordered, record that too. A different model or material can affect warranty, compatibility, and future servicing. When a job involves several invoices or deposits, point the work order to the Vendor Invoice Tracker so the operational record and payment record stay aligned without duplicating accounting details.
